DEVB TC(W) No. 8/2025
Digital Works Supervision System (DWSS) for Hong Kong
DWSS stands for Digital Works Supervision System, the system DEVB requires on Hong Kong capital works contracts above HK$30 million tendered from 1 April 2026. Kodifly delivers it complete on SpatialSense, built to Annex A of TC(W) No. 8/2025, with all six mandatory modules live within three months.
- Requirement
- DEVB TC(W) No. 8/2025 and its Annex A
- Who
- Capital works contracts with a pre-tender estimate above HK$30 million
- When
- Tendered on or after 1 April 2026
- Modules
- Six mandatory modules, plus Smart Construction Management and Smart Document Management
- Timeline
- Live demonstration within one month, commissioned within three months
- Cost cap
- HK$1.5 million or 1% of the pre-tender estimate, whichever is higher, capped at HK$10 million
- 6
- of 6 Annex A mandatory modules, live.
- 99.9%
- working-hours uptime, as Annex A requires.
- 24
- hours to open data to iCWP by API.
Everything Annex A asks for, included.
Also in the same record: 360, drone and LiDAR capture, dated and placed on the plan.
All 12 included
Request for Inspection (RISC)
Site Diary
Site Safety Inspection Records
Cleansing Inspection Checklists
Labour Return (G.F. 527)
Contract Management and NEC data
Smart Document Management
AI assistant for site records
Smart Construction Management hub
API to iCWP and third parties
Web, iOS and Android apps
Security, backup and audit trail
DWSS system, platform and app
A DWSS system, a DWSS platform and a DWSS app are the same thing. Annex A asks for one web platform with native mobile apps, built on three core components (Annex A 1.1.2).
Web: full access from a desktop or laptop browser over HTTPS, with no other software or licences (Annex A 1.6.1). App: a native iOS and Android app that uses the camera, GPS, messaging and notifications, and works for all three components (1.6.3, 1.6.4). Offline records are cached on the device and sync once a connection returns (5.7.3).
SpatialSense is the system, the platform and the app. Kodifly delivers all three as one project.
The three DWSS components
Annex A 1.3
Smart Construction Management
The data hub for sensors, AI cameras and other smart site applications.
Annex A 1.4
Smart Document Management
Correspondence, submissions and drawings, replacing the separate EDMS.
One DWSS, every circular connected.
DWSS · Integrations
TC(W) No. 8/2025- Co-supervision PlatformTC(W) No. 1/2026 · synced 2 min agoConnected
- Smart Site Safety SystemTC(W) No. 3/2023 · synced 2 min agoConnected
- Drone progress monitoringTC(W) No. 9/2025 · synced 6 min agoConnected
- AI adoptionTC(W) No. 3/2026 · synced 9 min agoConnected
- BIM as-builtTC(W) No. 1/2025 · synced 14 min agoConnected
Findings tied to the place they came from.
Pin an issue in the 360 view and assign it. It stays attached to its photo and date, from walk to report.
Every RISC request on one clock.
A request moves from submitted to inspected to approved in one record. The allowable time counts down beside it, so a late reply shows before it turns into a dispute.
Walk through your DWSS tender
Ask your records a question.
Ask which RISC forms on Level 5 are still open. The answer lists its source records, pins them on the model and exports to Word.
Drawings and transmittals in one register.
Every revision and transmittal sits in Drive with its status. A retention rule sets how long each record is kept.
Live in three months.
Within one month
Live demonstration for approval.
Within eight weeks
Proposal, workflows and interfaces.
Within three months
DWSS commissioned and running.
Read with these circulars
Guides and detail pages

Cleansing inspection
What the DWSS Cleansing Inspection Checklists module must do under TC(W) No. 8/2025 Annex A: daily and weekly checklists, records, workflow, statistics and SpatialSense.

Contract management
What the DWSS Contract Management module must do under TC(W) No. 8/2025 Annex A: compensation events, early warnings, payment, programme, NEC Health Check data.

Glossary
A sourced glossary of DWSS terms in Hong Kong public works: DWSS, iCWP, DSR, RISC, SCM, SDM, EDMS, SSSS or 4S, CSP, NEC and PTE, with the circular paragraph for each.

How to choose
How to choose a DWSS for Hong Kong public works. Nine criteria from TC(W) No. 8/2025 Annex A, questions to ask any vendor, red flags, and how Kodifly answers each.

iCWP data standard
How a DWSS feeds DEVB's iCWP under TC(W) No. 8/2025. The data standardisation rule, the 24-hour API clause, what data flows and how SpatialSense meets it.

Labour Return
What the DWSS Labour Return module must do under TC(W) No. 8/2025 Annex A: every G.F. 527 field, retrieval from the Site Diary, workflow, statistics and SpatialSense.

RISC
The RISC form in the DWSS under TC(W) No. 8/2025 Annex A 7.5: the form it digitises, fields, workflow and sign-off, dashboard, and how SpatialSense delivers it.

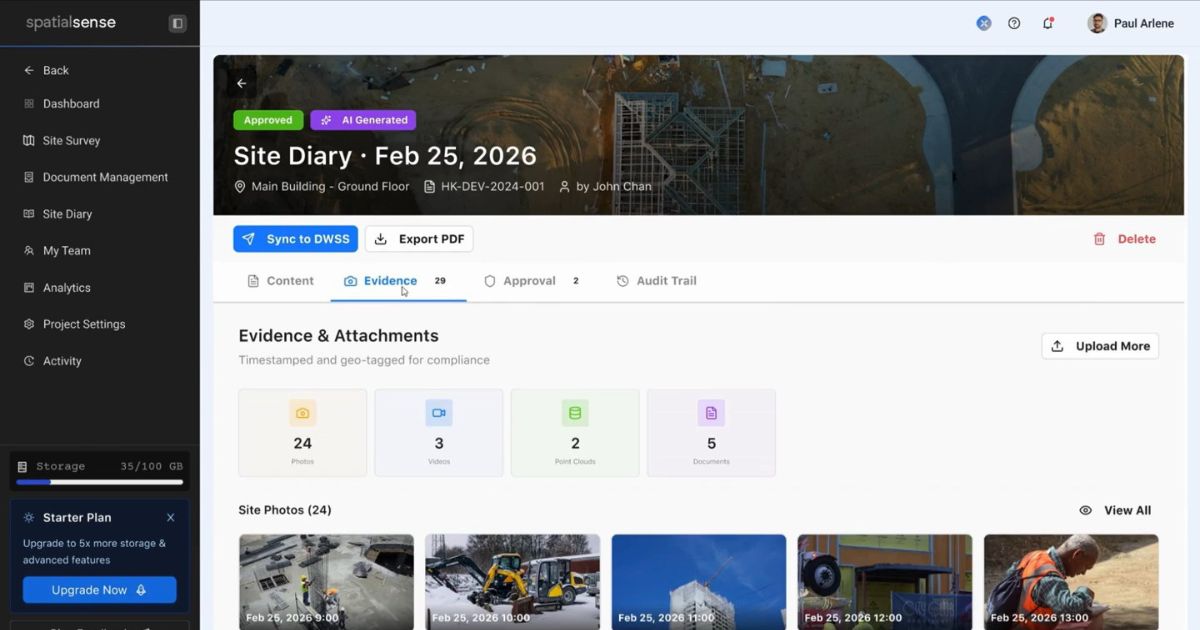

Site Diary
What the DWSS Site Diary module must do under TC(W) No. 8/2025 Annex A 7.5: G.F. 536, Site Record Book, content, workflow, statistics, and how SpatialSense delivers it.

Site safety inspection
What the DWSS Site Safety Inspection Records module must do under TC(W) No. 8/2025 Annex A: safety walks, performance records, workflow, statistics and SpatialSense.

Smart construction management
Smart construction management in the DWSS under TC(W) No. 8/2025: the SCM hub, alerts, dashboards, iCWP data within 24 hours, the AI tool, and how SpatialSense meets it.

TC(W) No. 8/2025
DEVB TC(W) No. 8/2025 in plain terms. Who must adopt the DWSS, the HK$30 million threshold, 1 April 2026, changes from TC(W) No. 2/2023, cost ceiling, EDMS and audit.

Tender checklist
A clause-by-clause checklist of DEVB TC(W) No. 8/2025 Annex A for DWSS tenders: proposal contents, access, security, backup, availability, timeline, handover and AI.
DWSS questions
What does DWSS stand for?
DWSS stands for Digital Works Supervision System. In Chinese it is 數碼工程監督系統. DEVB TC(W) No. 8/2025 requires it on Hong Kong capital works contracts above HK$30 million tendered on or after 1 April 2026.
Is the DWSS a system, a platform or an app?
All three. Annex A asks for one web platform reached from a desktop browser over HTTPS with no other software (1.6.1), plus native iOS and Android apps that use the camera, GPS and notifications (1.6.3). SpatialSense delivers the web platform and both apps.
What is a DWSS?
A Digital Works Supervision System is the web-based portal DEVB requires on Hong Kong capital works contracts above HK$30 million tendered on or after 1 April 2026. It digitises the mandatory site forms and records (RISC, site diary, safety and cleansing inspections, labour returns and contract management), collects data from smart site applications, and holds the formal project documents (paragraph 9, Annex A 1.1).
Which DWSS is available in Hong Kong?
Kodifly's SpatialSense is a complete DWSS built to Annex A of TC(W) No. 8/2025, with all six mandatory modules, Smart Document Management and AI built in, plus 360, drone and LiDAR capture in the same dated record. The circular sets requirements rather than naming products, so compare any proposal against Annex A.
What are the six mandatory DWSS modules?
Request for Inspection / Survey Check (RISC) with linked history and a status dashboard, Site Diary / Site Record Book, Site Safety Inspection Records, Cleansing Inspection Checklists, Labour Return Record covering every field of G.F. 527, and Contract Management with compensation events, instructions, early warnings, programme, payment and NEC Health Check data (Annex A 7.5).
Which contracts must adopt the DWSS?
Capital works contracts, including capital subventions contracts under Head 708, with a pre-tender estimate above HK$30 million and tendered on or after 1 April 2026. Earlier contracts implement the enhancements as far as practicable, and bureaux and departments should adopt it in other works contracts such as maintenance and term contracts.
How soon must a DWSS be running after the contract starts?
Annex A 3.1 asks for a live demonstration within one month of commencement, a proposal within eight weeks and commissioning within three months, or as agreed with the employer's representative.
Do we still need a separate EDMS?
No. Contractors are no longer required to procure a separate Electronic Document Management System, because the Smart Document Management component within the DWSS fulfils those requirements (paragraph 11).
How much should a DWSS cost?
The estimated cost would normally not exceed HK$1.5 million or 1% of the pre-tender estimate, whichever is higher, with a cap of HK$10 million. Exceeding it needs approval from an officer at D2 rank or above. It does not form part of the contract computer facilities estimate (paragraph 12).
Are smart site devices part of the DWSS?
No. The DWSS is the platform that collects and consolidates smart site data. The smart site applications and devices themselves do not form part of the DWSS, so their cost sits outside the DWSS estimate (paragraph 12, footnote 2). Kodifly can supply the devices and the Smart Site Safety System as separate items.
What happens at handover and audit?
The DWSS is handed over to the employer at completion, a professional-rank project team member and a resident site staff member manage it, and its proper adoption and use is a standard item in technical audits (paragraphs 15 and 16, Annex A 11.2; project team in 3.2).
Walk through your DWSS tender
Send us the contract, estimate and tender date. We will show SpatialSense against your clauses.
